Permitting and Code
for Graywater Systems
Obey the law
Design safe and healthy systems. Educate yourself as to how to follow code guidelines for permit-exempt systems and obtain necessary permits where required.
The 3 Types of Graywater Systems as Defined by CA Code
Clothes Washer System (1602.1.1)
Doesn't alter drainage plumbing
Follows 12 guidelines
Doesn’t need permit
Simple System (1602.1.2)
Up to 250 gallons/day or less
Any amount of fixtures
Needs permit
Complex System (1602.1.3)
Over 250 gallons/day, any amount of fixtures, designed by a person who demonstrates competence, needs permit
Key points
from the Graywater Code
Discharge (1602.2.1)

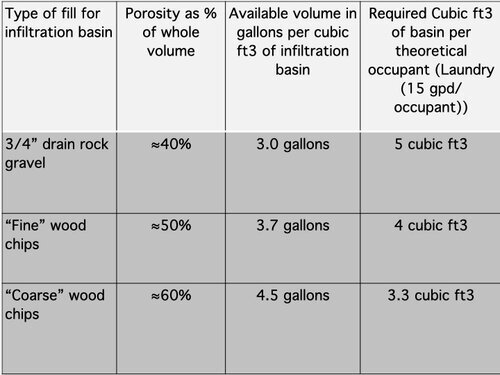

To a subsurface/subsoil irrigation system/disposal field
Residential occupancies can discharge to a mulch basin
Surge Capacity (1602.2.2)
Designed system must accommodate peak flow rates and discharge all water on a daily basis
A surge tank is required for systems that can’t discharge the total amount by gravity drainage
Diversion (1602.2.3)
Must occur downstream of traps and vent connections
The diverter valve must be readily accessible and indicate flow direction
Backwater Valves (1602.2.4)
Install at the point of connection to the building sewer system for locations that are subject to backflow
Permitting Requirements
Check with the jurisdiction in which the graywater system is being installed.
Drawings and Specifications(1602.7)
Plot plan details
Holding tank details

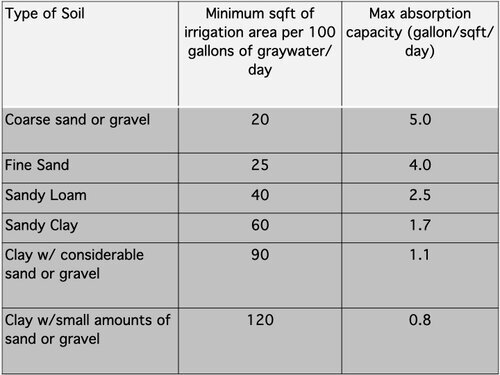

Soil absorption qualities from percolation test
Site Surface water locations
Operations and Maintenance Manual (1601.6)
Diagrams of the system and location of components.
How and when to turn the system off and on.
Appropriate products to use
Any maintenance needed
Contact info for the installer and/or manufacturer
Pictures and other documentation of the piping before it is buried
Licensed professional for complex systems (1601.2)
“Complex Systems” are defined as those producing over 250 gallons/day, from any amount of fixtures.
Design may require a licensed professional.
• Civil Engineer
